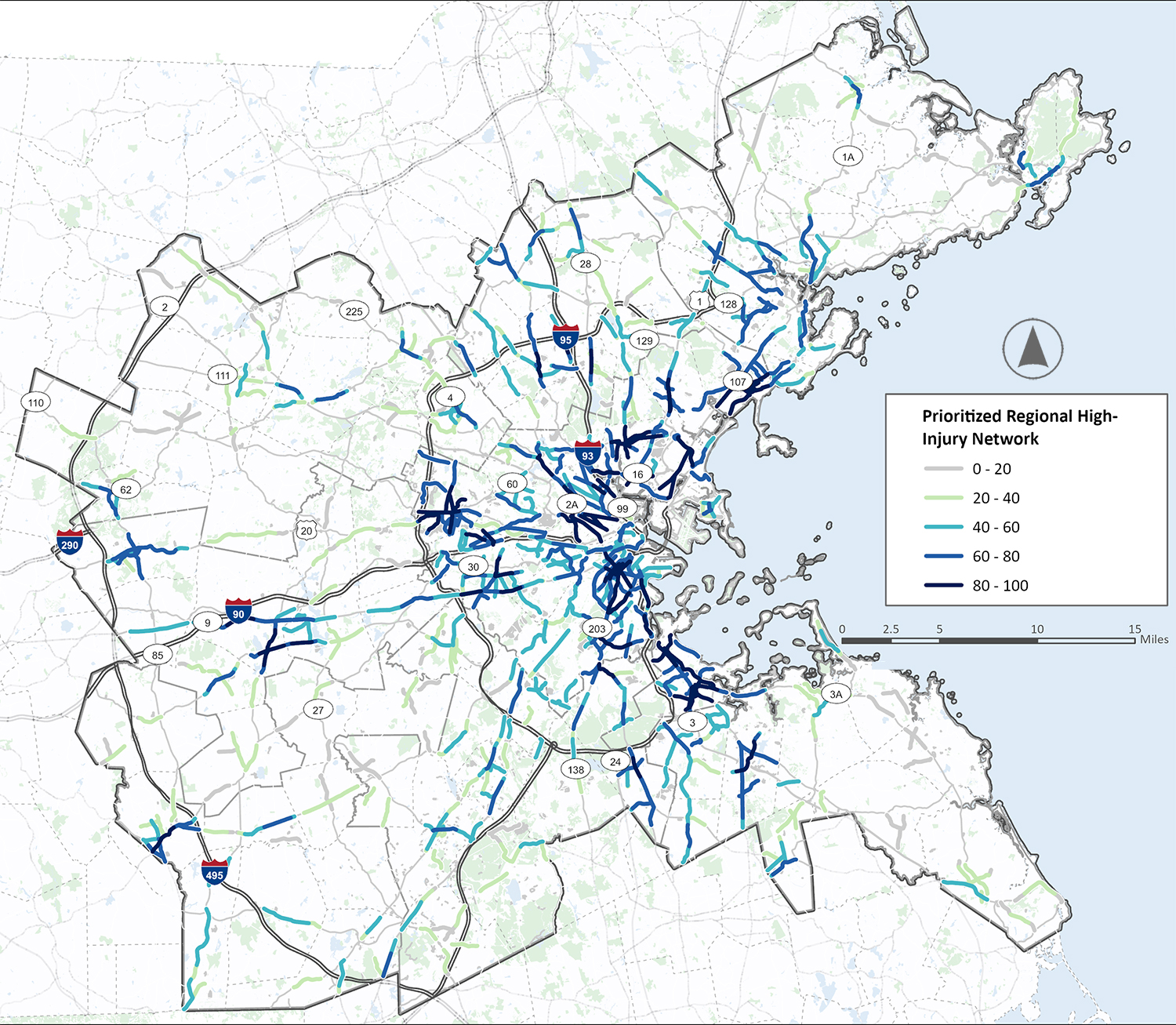

Figure 3.7 | Prioritized Regional High-Injury Network

Figure 3.8 | Prioritized HIN in the ICC Subregion

Figure 3.9 | Prioritized HIN in the MAGIC Subregion

Figure 3.10 | Prioritized HIN in the MetroWest Subregion

Figure 3.11 | Prioritized HIN in the NSPC Subregion

Figure 3.12 | Prioritized HIN in the NSTF Subregion

Figure 3.13 | Prioritized HIN in the SSC Subregion

Figure 3.14 | Prioritized HIN in the SWAP Subregion

Figure 3.15 | Prioritized HIN in the TRIC Subregion

Figure 3.16 | High-Risk Network Example—Lane Departure Crashes

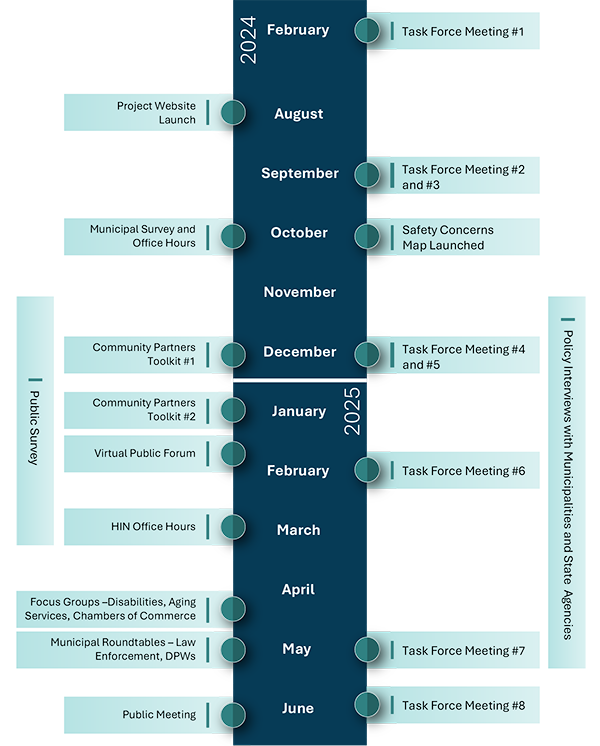

Figure 4.1 | Engagement Timeline

About the Plan

Boston Region Vision Zero Action Plan

JUNE 26, 2025

This plan was funded in part through grants from the U.S. Department of Transportation (U.S. DOT). Its contents do not necessarily reflect the official views or policies of the U.S. DOT.

MPO Logo

About the Boston MPO

The Boston Region Metropolitan Planning Organization (MPO) is responsible for conducting the federally required metropolitan transportation planning process for the Boston metropolitan area. The MPO encompasses 97 cities and towns, covering approximately 1,360 square miles and stretching from Boston to Ipswich in the north, Marshfield in the south, and to approximately Interstate 495 in the west. Cooperatively selecting transportation programs and projects for funding is a role of the MPO’s 23 voting members, which includes state agencies, regional entities, and municipalities. The work of the MPO is performed by the Central Transportation Planning Staff under the direction of the MPO Board. The MPO is composed of:

Permanent Members

Elected Members

Nonvoting Members

A map of the Boston Regional MPO, encompassing the wider Boston metropolitan region. The map shows municipal borders and divides the area into  eight subregions: the North Shore Task Force (NSTF) encompassing communities along the shores to the Northeast of Boston, the North Suburban Planning Council (NSPC), a band of communities directly north of Boston, the Minuteman Advisory Group on Interlocal Coordination (MAGIC), communities stretching to the northwest from Lexington to Acton, the MetroWest Regional Collaborative (MetroWest), communities to the immediate west of Boston, the SouthWest Advisory Planning Committee (SWAP), a group of communities to the far southwest of Boston,  the Three Rivers Interlocal Council (TRIC), communities to the south of Boston centered on Norwood, the South Shore Coalition (SSC), the coastal communities southeast of Boston, and the Inner Core Committee (ICC), encompassing the city Boston and its immediate neighbors.

Acknowledgements

[MPO TO DRAFT TEXT TO INSERT]

Notice of Nondiscrimination Rights and Protections

The Boston Region Metropolitan Planning Organization (MPO) operates its programs, services, and activities in compliance with federal nondiscrimination laws including Title VI of the Civil Rights Act of 1964 (Title VI), the Civil Rights Restoration Act of 1987, and related statutes and regulations. Title VI prohibits discrimination in federally assisted programs and requires that no person in the United States of America shall, on the grounds of race, color, or national origin (including limited English proficiency), be excluded from participation in, denied the benefits of, or be otherwise subjected to discrimination under any program or activity that receives federal assistance. Related federal nondiscrimination laws administered by the Federal Highway Administration, Federal Transit Administration, or both, prohibit discrimination on the basis of age, sex, and disability. The Boston Region MPO considers these protected populations in its Title VI Programs, consistent with federal interpretation and administration.

The Boston Region MPO also complies with the Massachusetts Public Accommodation Law, M.G.L. c 272 sections 92a, 98, 98a, which prohibits making any distinction, discrimination, or restriction in admission to, or treatment in a place of public accommodation based on race, color, religious creed, national origin, sex, sexual orientation, disability, or ancestry. Likewise, the Boston Region MPO complies with the Governor’s Executive Order 526, section 4, which requires that all programs, activities, and services provided, performed, licensed, chartered, funded, regulated, or contracted for by the state shall be conducted without unlawful discrimination based on race, color, age, gender, ethnicity, sexual orientation, gender identity or expression, religion, creed, ancestry, national origin, disability, veteran’s status (including Vietnam-era veterans), or background.

A complaint form and additional information can be obtained by contacting the MPO or at http://www.bostonmpo.org/mpo_non_discrimination. To request this information in a different language or in an accessible format, please contact:

TITLE VI SPECIALIST

Boston Region MPO

10 Park Plaza, Suite 2150

Boston, MA 02116

civilrights@ctps.org

BY TELEPHONE: 857.702.3700 (voice)

For people with hearing or speaking difficulties, connect through the state MassRelay service:

Relay Using TTY or Hearing Carry-over: 800.439.2370

Relay Using Voice Carry-over: 866.887.6619

Relay Using Text to Speech: 866.645.9870

For more information, including numbers for Spanish speakers, visit https://www.mass.gov/massrelay

Message from the Executive Director

1 Introduction

What is the Vision Zero Action Plan?

In 2024, close to 40,000 people were killed in traffic crashes in the United States and hundreds of thousands more were seriously injured. This national roadway safety problem affects us in the Boston Region as well, where traffic crashes continue to kill or seriously injure over 1,000 people per year.

A stacked bar graph showing serious injuries and fatalities from 2018 to 2019. Serious injuries declined from 939 in 2018 to 779 in 2020, but has since increased to 1,066 in 2022. Fatalities show a more moderate trend, starting with 99 in 2018 and increasing to 142 in 2022.

The Boston Region Metropolitan Planning Organization (MPO) believes that even one death on our roads is too many, that’s why we’re committed to Vision Zero. Vision Zero is an approach to roadway safety that’s based on the assumption that serious traffic crashes are preventable. Together, we can change how we design, operate, and maintain our streets in order to make the region safe for all road users—whether you walk, roll, bike, ride transit, or drive.

The MPO’s Long Range Transportation Plan (LRTP), Destination 2050, sets a goal to achieve zero transportation-related fatalities and serious injuries and improve safety for all users of the transportation system:

The Boston Region Vision Zero Action Plan reflects the MPO’s commitment to saving lives. This Action Plan builds on transportation planning and safety initiatives already undertaken in the region. This effort will help the MPO and its 97 municipalities navigate the future of roadway safety and communicate clearly with residents about how we can implement safety improvements necessary to achieve Vision Zero.

What is Vision Zero?

The traditional approach to roadway safety views traffic deaths and serious injuries as “inevitable side effects of modern life” (Vision Zero Network) and refers to these serious crashes as “accidents.” Vision Zero asks us to realize that we can, in fact, prevent serious crashes by proactively prioritizing traffic safety.

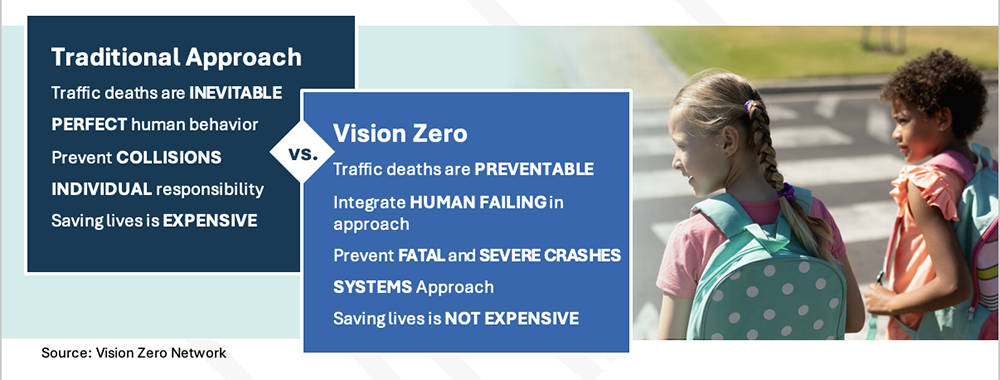

Two older children with backpacks watching traffic while waiting to use a crosswalk.

Vision Zero recognizes that people will not act perfectly on our streets, and calls on elected officials, policy makers, engineers, planners, first responders, public health professionals, and others to integrate human mistakes into our safety work.

Vision Zero calls on us to work together, across disciplines, to improve roadway safety. There are many complex factors that contribute to roadway safety and safe mobility, including street design, vehicle speeds, roadway user behaviors, and vehicle technology. However, we can design roads, update policies, and implement new programs to lessen the severity of crashes. Reaching zero fatalities and serious injuries requires us to set goals and work on actions to implement change in all of these areas.

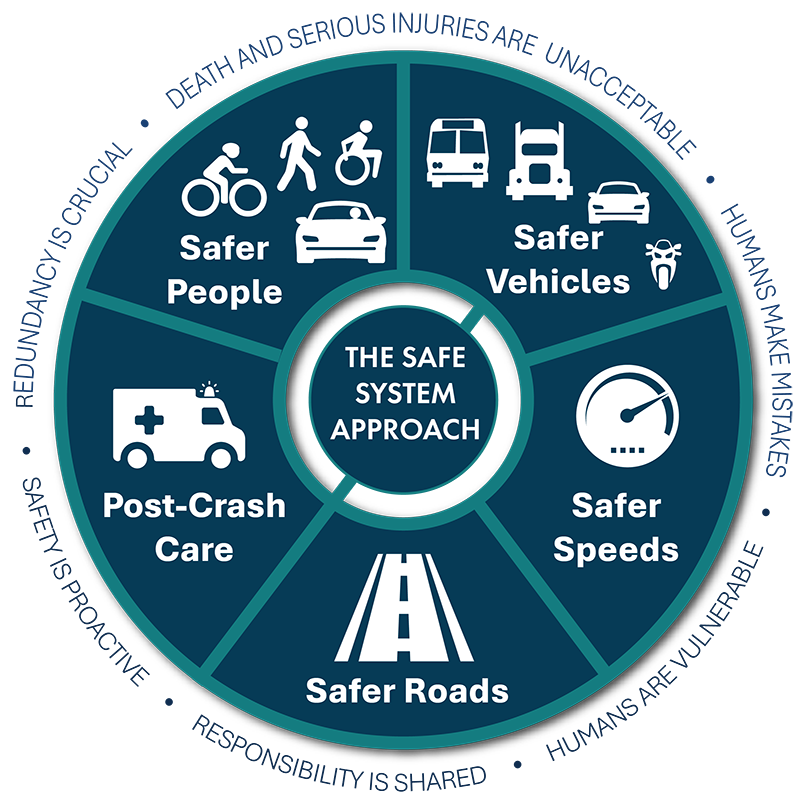

Figure 1.1 | Safe System Approach Principles and Elements

A circular segmented pie infographic showing the various components of the Safe System Approach. With the Safe System Approach at the center, five components surround the outer edge: Safer People, Safer Vehicles, Safer Speeds, Safer Roads, and Post-Crash Care. Circumscribing the outside of the wedges is a ring of six statements: Death and Serious Injuries Are Unacceptable, Humans Make Mistakes, Humans Are Vulnerable, Responsibility is Shared, Safety is Proactive, and Redundancy is Crucial.

The Safe System Approach

While Vision Zero establishes the goal of zero deaths and serious injuries on our streets, the Safe System Approach, illustrated in Figure 1.1, provides a more detailed framework for how we reach that goal. The Safe System Approach aims to address and mitigate the risks inherent in the transportation system by building and reinforcing multiple layers of protection to both prevent crashes from happening in the first place and minimize the harm caused to those involved when crashes do occur.

This holistic and comprehensive strategy focuses both on human mistakes and vulnerability and promotes a system designed with many redundancies in place to protect all road users. The Safe System Approach also embraces all types of roadway safety countermeasures and acknowledges that a multi-disciplinary approach is required to address the full range of possible safety risks. Figure 1.1 shows how the five Safe System elements—safe road users, safe vehicles, safe speeds, safe roads, and post-crash care—work together to create shared responsibility for the safety of all road users.

Safe Streets and Roads for All (SS4A)

In 2023, the U.S. Department of Transportation (U.S. DOT) awarded the MPO a Safe Streets and Roads for All (SS4A) Planning and Demonstration Grant to develop a comprehensive roadway safety action plan. This Action Plan is the primary deliverable of this federal assistance and fully reflects the program’s priorities. Appendix J includes a checklist that shows how this comprehensive safety action plan aligns with all Federal requirements for this grant program

2 How the Plan was Developed

Process to Prepare the Plan

Table 2.1 | Relation to Other Strategic Safety Plans

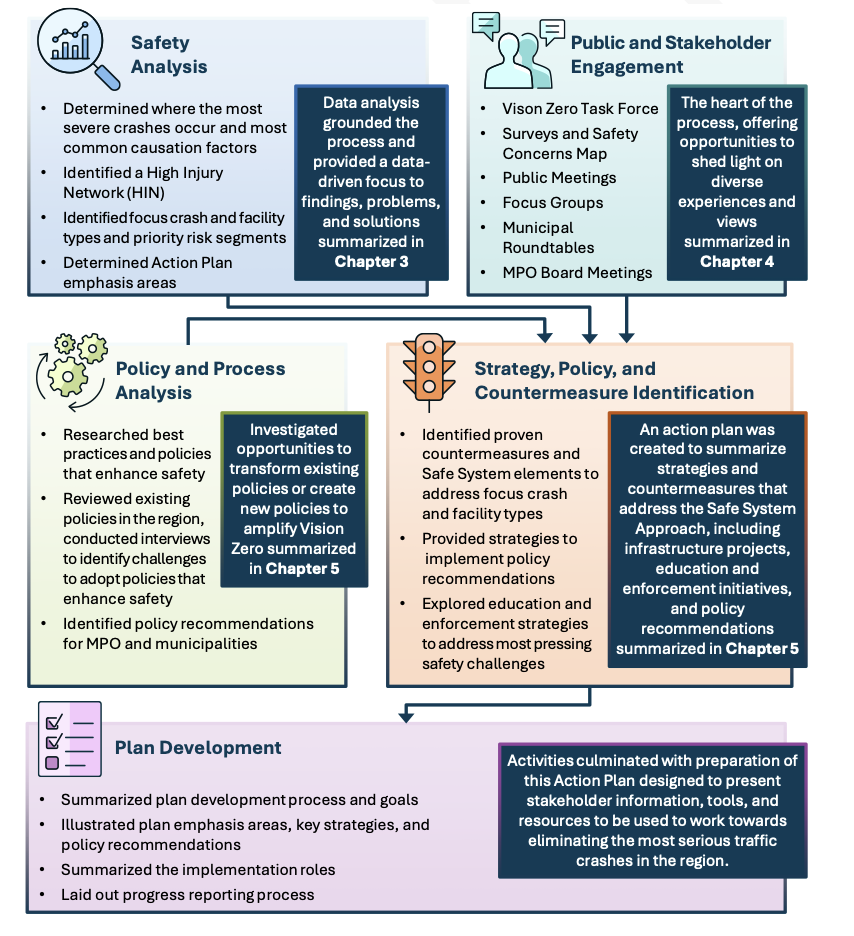

A flow chart illustrating the Vision Zero Action Plan Development Process. Safety Analysis, Public and Stakeholder Engagement, and Policy and Process Analysis all contributed to Strategic and Countermeasure Identification, which then led to Plan Development.
Long Description:
Title: Vision Zero Action Plan Development Process
Safety Analysis
•	Determined where the most severe crashes occur and most common causation factors
•	Identified a High Injury Network (HIN)
•	Identified focus crash and facility types and priority risk segments
•	Determined Action Plan emphasis areas
Data analysis grounded the process and provided a data-driven focus to findings, problems, and solutions summarized in Chapter 3
Public and Stakeholder Engagement
•	Vison Zero Task Force
•	Surveys and Safety Concerns Map
•	Public Meetings
•	Focus Groups
•	Municipal Roundtables
•	MPO Board Meetings
The heat of the process, offering opportunity to shed light on diverse experiences and views summarized in Chapter 4
Policy and Process Analysis
•	Researched best practices and policies that enhance safety
•	Reviewed existing policies in the region, conducted interviews to identify challenges to adopt policies that enhance safety
•	Identified policy recommendations for MPO and municipalities
Investigated opportunities to transform existing policies or create new policies to amplify Vision Zero summarized in Chapter 5
Strategy, Policy, and Countermeasure Identification
•	Identified proven countermeasures and Safe System elements to address focus crash and facility types
•	Provided strategies to implement policy recommendations
•	Explored education and enforcement strategies to address most pressing safety challenges
An action plan was created to summarize strategies and countermeasures that address the Safe System Approach, including infrastructure projects, education and enforcement initiatives, and policy recommendations summarized in Chapter 5
Plan Development
•	Summarized plan development process and goals
•	Illustrated plan emphasis areas, key strategies, and policy recommendations
•	Summarized the implementation roles
•	Laid out progress reporting process
Activities culminated with preparation of this Action Plan designed to present stakeholder information, tools, and resources to be used to work towards eliminating the most serious traffic crashes in the region.

Relation to Other Safety Plans

Several other transportation and safety plans were referenced during the creation of this Vision Zero Action Plan, as noted in Table 2.1.

Table 2.1 | Relation to Other Strategic Safety Plans

Resource

Destination 2050

This Action Plan will address safety needs documented in the MPO’s LRTP. The LRTP also sets a goal of achieving zero crash fatalities in the region by 2050.

MetroCommon 2050

This Action Plan is aligned with MAPC’s 2021 regional land use and policy plan, which sets the goals of having safe transportation and healthy and safe neighborhoods.

Transportation Improvement Plan (TIP)

This Action Plan suggests priority corridors that could develop into projects funded through the MPO’s capital plan.

Beyond Mobility

This Action Plan aligns with the needs and actions identified in Massachusetts’ 2050 Transportation Plan.

Massachusetts Strategic Highway Safety Plan (SHSP)

This Action Plan’s safety analysis, emphasis areas, and proposed strategies and countermeasures are consistent with the goals of MassDOT’s SHSP.

Massachusetts Highway Safety Improvement Program (HSIP)

This Action Plan lists many infrastructure safety projects that may be eligible for support from MassDOT’s HSIP.

Vision Zero Plans and Safety Studies by the region’s cities and towns

Several MPO members have developed their own Vision Zero Plans, many of which were consulted. This Action Plan provides additional projects and countermeasures that these cities and towns can adopt:

Other municipalities are in the process of developing plans or demonstration projects, including Chelsea, Needham, Peabody, Qunicy, and Watertown.

3 Safety Analysis

An in-depth safety analysis, provided as Appendix B, forms a critical foundation for this Vision Zero Action Plan. This analysis identified where and why crashes are occurring across the Boston region, helped the MPO to assess current safety performance, supported data-driven decision-making by stakeholders and the Vision Zero Task Force, and guided the development of targeted safety strategies.

Key Crash Trends and Emphasis Areas

To better understand current crash patterns and the contributing factors associated with the most common and overrepresented crash types, the most recent five-year crash data were analyzed to help identify key factors that may contribute to future crashes.0F1

Data Sources

1.     Historical data (1980–2022) from the U.S. DOT Fatality Analysis Reporting System (FARS)

2.     Most recent five years (2018–2022) of available data from the MassDOT Open Data Portal and the MassDOT IMPACT tool

As described in Chapter 1, nearly 1,000 people are killed or seriously injured in crashes in the region every year. Figure 3.1 shows the breakdown of fatal and serious injury crashes by mode from 2018 through 2022. Bicyclists, pedestrians, and motorcyclists are at significant risk for serious injury or death when involved in crashes with motor vehicles.

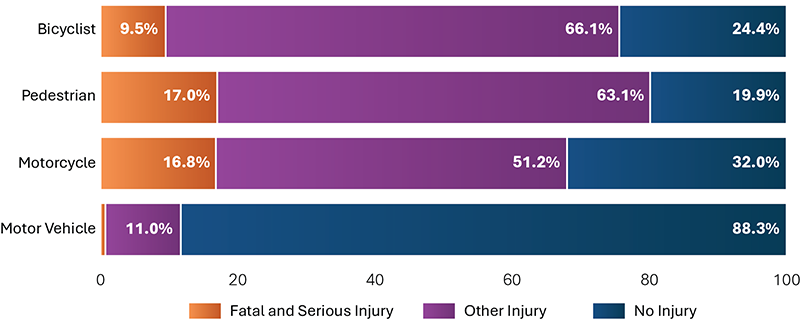

Figure 3.1 | Total Fatal and Serious Injury Crashes by Mode, 2018–2022

A stacked, horizontal bar graph showing percentages of total fatal and serious injury crashes by mode from 2018–2022, illustrating that vulnerable road user crashes are significantly more likely to result in a fatality, serious injury, or other injury compared to crashes with just motor vehicles. Motor vehicle crashes involved a very small amount of fatal and serious injury crashes, 11% other injuries, but the remaining 88.3% involving no injury. In contrast, Motorcycle and Pedestrian crashes each involved about 17% fatal and serious injuries, as well as 51.2% and 63% other injuries respectively. Bicyclist crashes similarly showed 9.5% fatal and serious injuries and 66.1% other injuries.

Crashes create costs that are born not just by victims and survivors but by our entire community in the form of insurance premiums, taxes, congestion-related costs, and workplace losses. From 2018 through 2022 in the Boston Region alone, crashes incurred an estimated total cost of $26.5 billion, averaging around $5.3 billion per year. Of that total, $12.2 billion (or 46 percent) came from fatal and serious injury crashes.

By pinpointing where and how fatal and serious injury crashes happen, we can better understand the underlying causes of crashes.

Where are Crashes Happening?

Figure 3.3 shows that principle and minor arterials have the highest proportion of fatal and serious injury crashes. Crashes involving people walking, rolling, and bicycling are also more prevalent on principal and minor arterials—where fast vehicles and non-motorized traffic mix, often in a dangerous way.

Most roads are managed, or owned, by either a municipality, MassDOT, or the Department of Conservation and Recreation (DCR) . Figure 3.4 shows that most fatal and serious injuries occur on locally owned roads. This suggests a significant proportion of improvements to advance safety are actionable by municipalities in the region.

Figure 3.2 | All Fatal and Serious Injury Crashes by Roadway Type, 2018–2022

A pie chart showing fatal and serious injury crashes by roadway type. Most such crashes occur on principal arterials (38%) and minor arterials (33%), with less on major collectors (15%) and local roads (13%). The fewest such crashes occur on minor collectors (less than 1%).

Figure 3.3 | All Fatal and Serious Injury Crashes by Road Ownership, 2018–2022

A pie chart showing fatal and serious injury crashes by road ownership. The overwhelming number of such crashes occur on municipality-owned roads (74.4%), followed by MassDOT-owned roads (17.6%). Fewer such crashes occur on DCR-owned roads (4.5%), roads owned by other jurisdictions (2.4%), and roads with unknown ownership (1.1%).

How are Crashes Happening?

Figure 3.4 illustrates that nearly 60 percent fatal and serious injury crashes involved two or more vehicles and approximately 40 percent were single vehicle crashes. Among single vehicle crashes resulting in a fatality or serious injury, the most common first harmful events were collisions with pedestrians at 35 percent.

Figure 3.4 | Fatal and Serious Injury Crashes by Collision Type, 2018–2022

A pie chart showing fatal and serious injury crashes by collision type. Most such crashes are single vehicle crashes (39.9%) or angle crashes (25.2%). Head-on (11.9%), rear-end (10.9%), and same-direction sideswipe crashes (4.4%) are common. The least amount of these crashes are opposite-direction sideswipes (2.6%), “other” crashes (2.4%), rear-to-rear crashes (0.2%), and crashes described as unknown/not reported (2.6%).

The data also shows us that crashes that happen at night are disproportionately more likely to result in fatalities or serious injuries, often due to increased impaired driving and speeding.

Emphasis Areas

To further determine the major crash types this Action Plan should focus on, the MPO examined emphasis areas for the Commonwealth identified by the Massachusetts Highway Safety Improvement Program (HSIP), which offer a helpful framework for identifying common crash issues, analyzing contributing factors, and linking them with a set of targeted countermeasures and strategies.1F2

In Table 3.1, emphasis areas that are more prevalent in the region compared to the Commonwealth are highlighted in bold. Data in this table do not include crashes along Interstates, expressways, other fully access-controlled roadways, or ramps.

Table 3.1 | Emphasis Areas

Massachusetts HSIP Emphasis Area

Boston Region

Massachusetts

Number of Fatal and Serious Injury Crashes

% of Total Fatal and Serious Injury Crashes

Percent Change from 2018 to 2022

% of Total Fatal and Serious Injury Crashes

Percent Change from 2018 to 2022

Intersections

1,756

44.1%

7.0%

39.7%

15.6%

Lane Departure

842

21.1%

42.8%

25.9%

37.7%

Older Drivers

837

21.0%

23.5%

20.0%

18.5%

Pedestrians

781

19.6%

-3.9%

14.9%

11.0%

Younger Drivers

449

11.3%

53.7%

12.7%

52.2%

Motorcyclists

424

10.6%

62.9%

14.5%

58.6%

Distracted Driving

314

7.9%

36.5%

8.9%

23.4%

Bicyclists

300

7.5%

92.3%

5.1%

60.9%

Impaired Driving

277

6.9%

23.9%

8.3%

48.0%

Large Vehicles

215

5.4%

20.0%

5.3%

27.2%

Speeding

205

5.1%

90.6%

6.6%

84.8%

Occupant Protection

182

4.6%

37.5%

4.8%

15.0%

Source:  Data Query and Visualization from MassDOT IMPACT Portal.

Note:      Percentages bolded are greater than the corresponding percentage in the entire Commonwealth of Massachusetts. Data in Table 3.1 does not include crashes along Interstates, expressways, other fully access-controlled roadways, or ramps.

Based on the prevalence and overrepresentation in the region’s fatal and serious injury crashes, the increasing rates of crashes observed over the past five years, and stakeholder input, Intersections, Lane Departure, Vulnerable Road Users, Older Drivers, Speeding, and Large Vehicles emerged as key Emphasis Areas (EA) for this Plan. These areas guide the focus of strategies and actions outlined below.

Intersection-Related Crashes: Intersection-related crashes were the most common type of fatal and serious injury crashes from 2018 to 2022, contributing to 44 percent of the region’s total. Particularly, crashes at four-way intersections and T-intersections accounted for the majority (94 percent) of fatal and serious injury intersection crashes.

Vulnerable Road User-Involved Crashes: From 2018 to 2022, while these crashes accounted for only 5 percent of total roadway crashes, they made up 27 percent of fatal and serious injury crashes within the region. Compared to other road users, Vulnerable Road Users were eight times more likely to be killed or seriously injured in a crash. The inclusion of this EA is further supported by the Vision Zero emphasis on these road users.

Lane Departure Crashes: Lane departure fatal and serious injury crashes increased steadily from 138 in 2018 to 197 in 2022, representing a 43 percent rise over five years. These crashes were often correlated with instances of impaired driving and speeding, emphasizing the importance of context-sensitive roadway design and awareness efforts targeting these high-risk behaviors.

Older Driver-Involved Crashes: Key risk factors associated with older drivers are age-related declines in physical and cognitive function, underlying medical conditions, individual driving habits, and limitations in roadway design and vehicle features. The older driver EA has one of the largest shares (21 percent) of all fatal and serious injury crashes between 2018 and 2022. Older drivers crashes are also overrepresented in the region compared to the rest of the Commonwealth.

Speeding-Related Crashes: The region experienced a substantial increase of 91 percent in speeding-related fatal and serious injury crashes from 2018 to 2022, one of the fastest growing areas of concern. Speeding is a key issue identified by many stakeholders.

Large Vehicle-Involved Crashes: Those involved in crashes involving large vehicles faced a particularly high risk of fatal or serious injury when not wearing seatbelts or those traveling at night. Other potential contributing coincidental factors included a lack of lane separation, high posted speed limits, and inadequate roadway lighting. Many stakeholders identified large vehicle safety as a key issue.

High-Injury and High-Risk Networks

The MPO carried out a network screening to identify and classify sites with road safety risks using a two-part approach. By addressing both specific and systemic safety needs, we build a Safe System through identification of a High Injury Network (HIN) and High-Risk Network (HRN

High-Injury Network (HIN)

A crash data-based approach that identifies locations with the highest concentrations of past fatal and serious injury crashes based on historical crash data. This method targets locations with the greatest potential for safety improvement and supports site-specific safety issue diagnosis and countermeasure development.

High-Risk (Systemic) Network (HRN)

A proactive approach that focuses on sites with the highest risk of future fatal and serious injury crashes based on the presence of contributing risk factors from a systemwide perspective. This method enables the implementation of low-cost proven countermeasures across the network to prevent future severe crashes.

High-Injury Network

The development of an HIN is a critical component of Vision Zero planning. An HIN is a data-driven tool to identify the small proportion of roads that result in the greatest number of serious injury and fatal injury crashes. This HIN uses data for 2018-2022 from the Registry of Motor Vehicles (RMV) and takes into account the following considerations:

To account for the differences in crash severity, crashes were weighted if they were more severe or if they involved vulnerable road users. Table 3.2 shows how each crash was scored along a corridor to develop the HIN.

Table 3.2 | Crash Scores by Severity

KABCO Severity Category

Non-VRU Crash Score

VRU Crash Score

Fatal Injury (K)

15

22.5

Suspected Serious Injury (A)

15

22.5

Suspected Minor Injury (B)

2

3

Possible Injury (C)

1

1.5

More details on how the HIN was developed are in Appendix C.

Key Findings

This network crash analysis resulted in two levels of severity of high-injury roads in the region:

The HIN provides valuable insight into how severe crashes are distributed across the roadway network. Regionally, HIN corridors make up just 7 percent of the roadway network by mileage, yet they account for approximately 65 percent of fatal and serious injury crashes between 2018 and 2022.

As shown in Figure 3.5, the regional HIN is heavily concentrated in and around the Inner Core Committee (ICC) subregion. This pattern is likely influenced by higher traffic volumes and increased levels of pedestrian and bicycle activity in the area, which lead to more frequent interactions among roadway users and a greater potential for conflicts.

Subregional and Municipal HINs

To provide a more context-sensitive understanding of corridors with severe crash concerns, subregional and municipal HINs were also developed. These finer-scale networks can support local municipalities in prioritizing safety improvements based on localized crash patterns. Municipalities can also partner with neighboring communities to implement coordinated safety projects along corridors that span municipal boundaries. To review the HINs in more detail, please visit https://www.bostonmpo.org/visionzero.

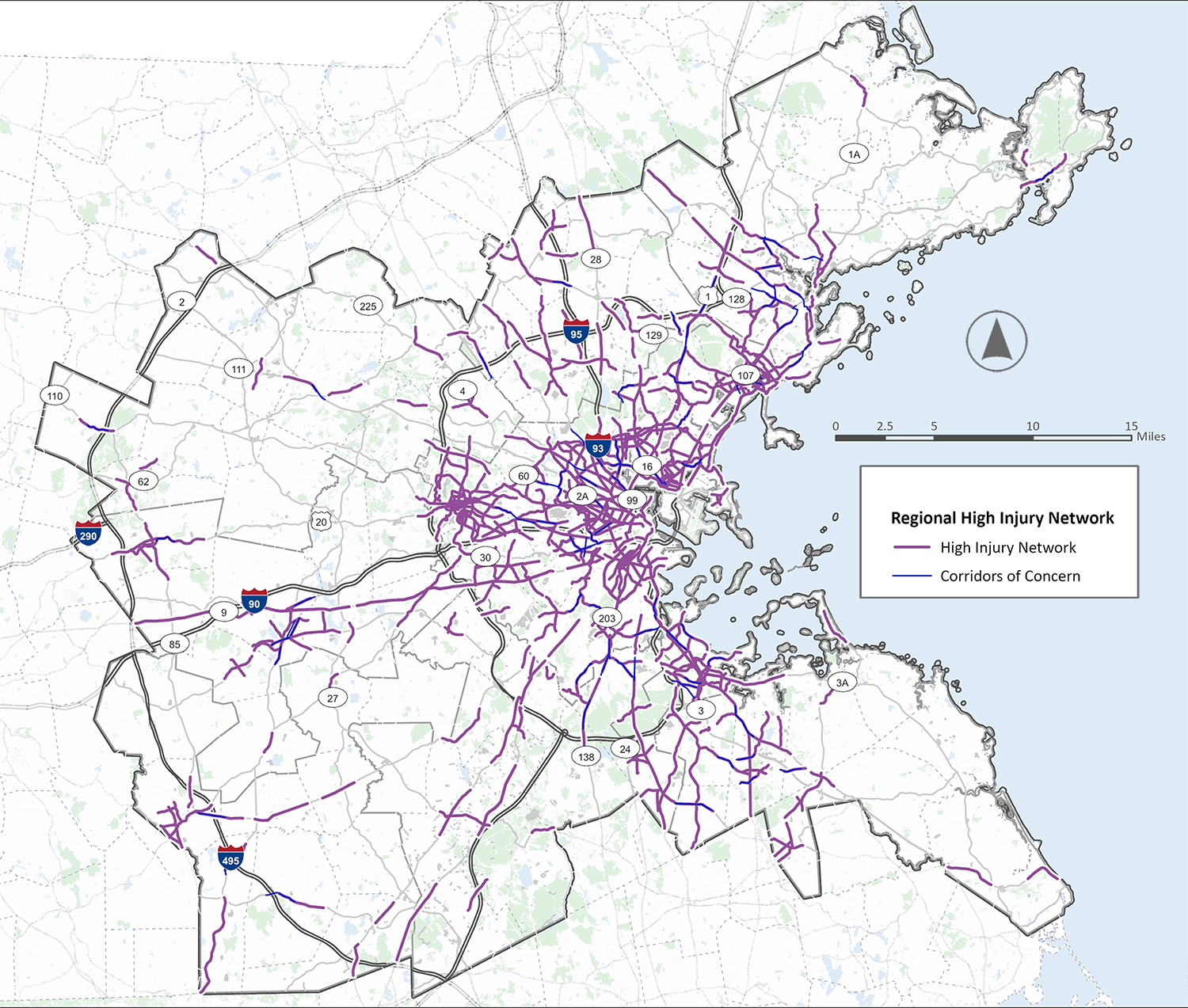

Figure 3.5 | Regional High-Injury Network

A map of the Boston area with the MPO region enclosed in a border. A Regional High Injury Network, consisting of highlighted high injury roadway segments and corridors of concern, is overlayed on the map. Most highlighted road segments are in the city of Boston, communities to the immediate north, and stretching along major roads to the northeast. There are also notable clusters around Waltham, Framingham, Marlborough, and Quincy/Weymouth

Priority Transportation Investment (PTI) Areas

To identify communities and neighborhoods that are disproportionally exposed to unsafe infrastructure, the geographic distribution of Priority Transportation Investment (PTI) populations was overlaid with the regional HIN to assess whether a greater share of HIN corridors falls within areas with high concentrations of PTI populations. PTI populations were defined based on the share of low-income, minority, and limited English proficiency residents in each Census tract. Figure 3.6 shows this overlay. Appendix C includes more detail on the methodology, analysis and findings to identify PTI areas.

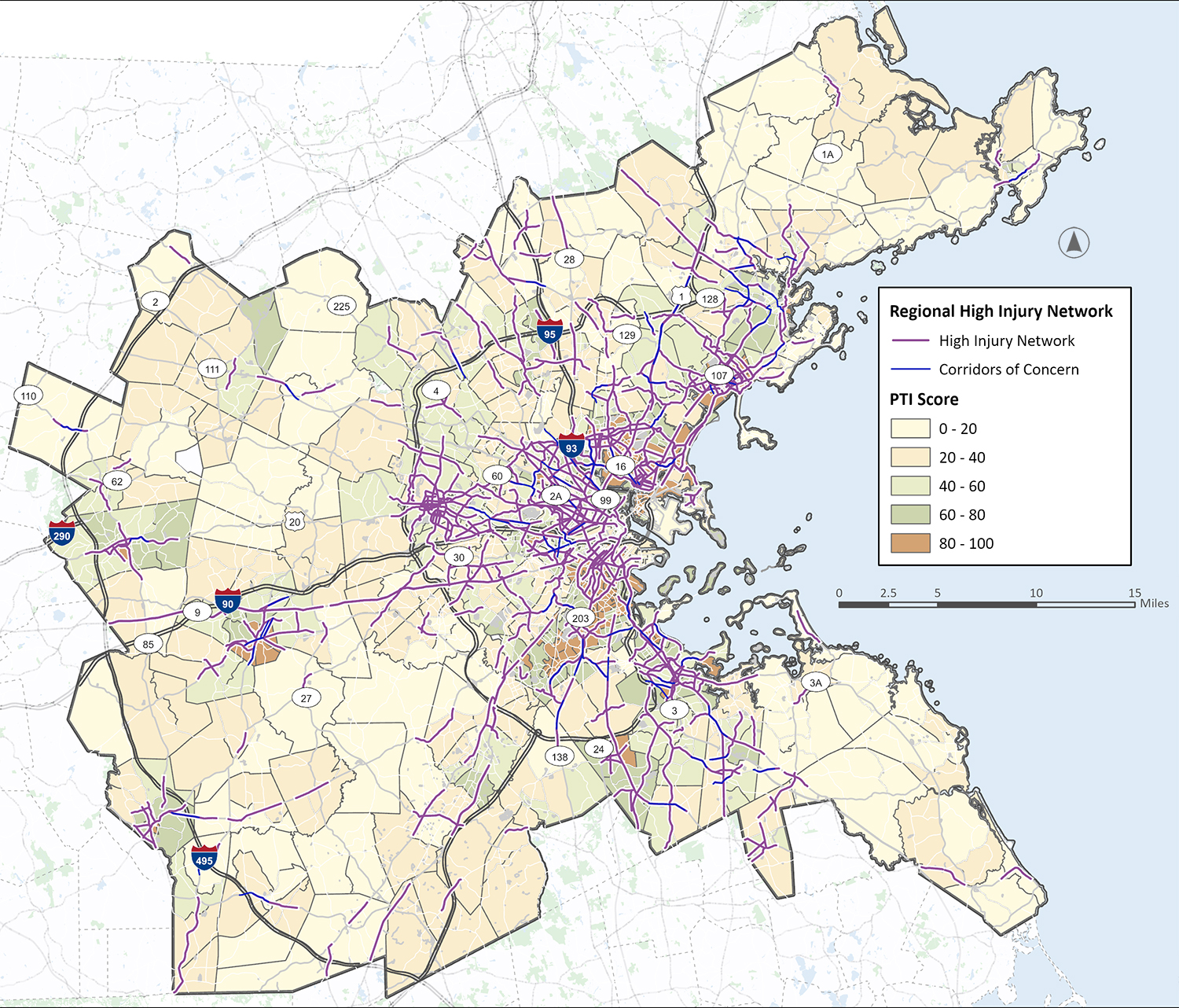

A map of the Boston area with the MPO region enclosed in a border. The Regional High Injury Network, consisting of highlighted high injury roadway segments and corridors of concern, is further overlayed with Priority Transportation Investment (PTI) Areas. The PTI areas are scored in fifths of 100 (0-20 being lowest scoring, 20-40, 40-60, 60-80, and 80-100 being highest scoring) This figure shows how the High Injury Network and some PTI areas overlap, notably in Waltham, Framingham, Marlborough, North Randolph, Quincy, areas of Roxbury, Grove Hall, and South End, and several communities to the immediate north of Boston.

Prioritized High-Injury Network

The priority network combines the HIN with other key criteria related to how people reach important destinations—whether the location is within a PTI community, has high rates of Vulnerable Road User travel, or is near transit stops, schools, hospitals, or other points of interest. The Prioritized HIN was developed at the regional, subregional, and municipal levels.

The networks were prioritized and scored from 0 to 100 using the screening elements and weights shown in Table 3.3, then normalized so that in each region, each subregion, or each municipality (depending on the network level), the highest score was 100 and the lowest score was 0. This final, normalized score is known as the priority score. The final regional prioritized network is shown in Figure 3.7.

Table 3.3 | Network Screening Elements

Network Screening Elements

Weight

Crash Score

50

Priority Transportation Investment Communities

20

Total Trip Activity

5

Vulnerable Road User Trip Activity

5

Presence of a Healthcare Facility

5

Presence of an Education Facility

5

Presence of a Transit Stop

5

Presence of Other Points of Interest

5

Maximum Total Score

100

Building on this analysis, a series of Municipal Safety Profiles were created, included as Appendix E. These profiles describe common infrastructure, behavioral, operational, and modal safety challenges specific to each municipality. They also integrate findings from the existing conditions analysis, the HIN, community outreach, and other components of the plan to provide a comprehensive, context-sensitive understanding of local safety issues.

Figure 3.7 | Prioritized Regional High-Injury Network

A map of the Boston area with the MPO region enclosed in a border. A Prioritized Regional High Injury Network, consisting of highlighted highest, scoring roadway segments, is overlayed on the map. Most high scoring, highlighted road segments are in the city of Boston, communities to the immediate north, and stretching along major roads to the northeast. There are also notable clusters around Waltham, Framingham, Milford, Newton, Quincy/Weymouth, areas of Roxbury, Grove Hall, South End, and Dorchester, and several communities to the immediate north of Boston, including Lynn and Salem.

High Scoring Corridors

The following maps and tables identify some of the highest-scoring corridors within each of the eight subregions. The identification of these top scoring corridors in each subregion helps illustrate how the MPO can use the prioritized HIN to start to focus in on the highest crash corridors that are in proximity to other mobility factors that the MPO prioritizes, such as transit, schools, and PTI areas. Next steps for what the MPO and municipalities can do to address safety concerns in these locations are detailed in the list of actions in Chapter 5.2F3

Figure 3.8 | Prioritized HIN in the ICC Subregion

A map of the Inner Core Community (ICC) Subregion, consisting of the inner core around the city of Boston. A Prioritized Regional High Injury Network, consisting of highlighted highest-scoring roadway segments, is overlayed on the map. This area has many high-scoring segments, in the city of Boston, South End/Roxbury, Dorchester, Quincy, Newton, Waltham, Lynn, and segments in Medford and Malden.

Table 3.4 | High-Scoring Locations in the ICC Subregion

Road

From

To

Ownership

Municipality

Washington St

Western Ave

Broad St

Local

Lynn

Liberty St

Market St

Baldwin St

Local

Lynn

Squantum St

Montclair Ave

Billings St

Local

Quincy

Hampshire St

Amory St

Broadway

Local

Cambridge

Massachusetts Ave

Columbus Ave

Pompeli St

Local

Boston

Figure 3.9 | Prioritized HIN in the MAGIC Subregion

A map of the Minuteman Advisory Group on Interlocal Coordination (MAGIC) Subregion, consisting of communities stretching to the northwest from Lexington to Acton. A Prioritized Regional High Injury Network, consisting of highlighted highest-scoring roadway segments, is overlayed on the map. This area has high-scoring segments in Marlborough, Hudson, Framingham, and around Concord, Lexington, and Acton.

Table 3.5 | High-Scoring Locations in the MAGIC Subregion

Road

From

To

Ownership

Municipality

Massachusetts Ave / Bedford St

Percy Rd

Hill St

Local

Lexington

Central St / Main St

Coolidge St

High St

Local

Hudson

Union Tpke

School St

Baker Ave Ext.

State

Concord

Washington St

Main St

Hudson St

Local

Hudson

Great Rd

Loomis St

North Rd

Local

Bedford

Figure 3.10 | Prioritized HIN in the MetroWest Subregion

A map of the MetroWest Regional Collaborative (MetroWest) Subregion, consisting of communities to the immediate west of Boston. A Prioritized Regional High Injury Network, consisting of highlighted highest-scoring roadway segments, is overlayed on the map. This area has high-scoring segments in Marlborough, Framingham, and Wellesley.

Table 3.6 | High-Scoring Locations in the MetroWest Subregion

Road

From

To

Ownership

Municipality

Concord St /
Holls St

Normandy Rd

Andrew St

Local

Framingham

Waverly St

Fountain St

2nd St

Local

Framingham

W Central St

Kendall Ln

Speen St

Local

Natick

Bolton St

Union St

South St

Local

Marlborough

Union St

Chestnut St

Indian Spring Rd

Local

Ashland

Figure 3.11 | Prioritized HIN in the NSPC Subregion

A map of the North Suburban Planning Council (NSPC) Subregion, consisting of a band of communities directly north of Boston. A Prioritized Regional High Injury Network, consisting of highlighted highest-scoring roadway segments, is overlayed on the map. This area has high-scoring segments in Malden and several north-south segments through Burlington, Woburn, Stoneham, Melrose, Ballardville, Hathorne, and Andover.

Table 3.7 | High-Scoring Locations in the NSPC Subregion

Road

From

To

Ownership

Municipality

Main St

Green St

Clinton St

Local

Woburn

Main St / Rt 28

Broadway

William St

State

Stoneham

Main St / Rt 28

William St

Middle St

Local

Stoneham

Washington St

Dragon Ct

Salem St

State

Woburn

Middlesex Tpke

I-95

Terrace Hall Ave

Local

Burlington

Figure 3.12 | Prioritized HIN in the NSTF Subregion

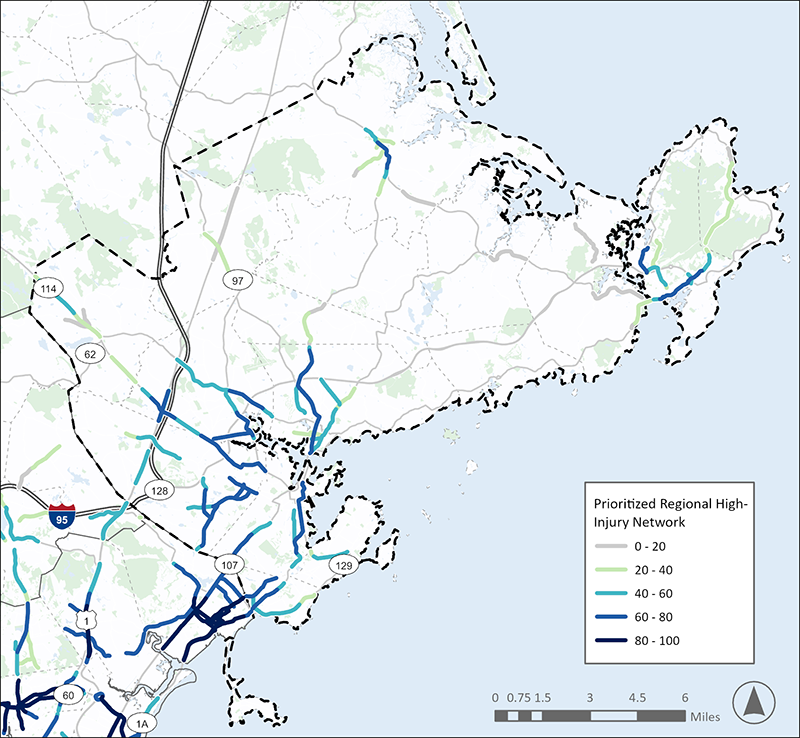

A map of the North Shore Task Force (NSTF) Subregion, consisting of communities along the shores to the Northeast of Boston. A Prioritized Regional High Injury Network, consisting of highlighted highest-scoring roadway segments, is overlayed on the map. This area has high-scoring segments in Lynn, Salem, Beverly, Danvers, and Gloucester.

Table 3.8 | High-Scoring Locations in the NSTF Subregion

Road

From

To

Ownership

Municipality

Rantoul St

Swan St

Pleasant St

Local

Beverly

Hawthorn Blvd / Winter St

Bridge St

Derby St

Local

Salem

Essex St

Beach Ave

Ryan Pl

Local

Swampscott

Lafayette St

New Derby St

Hancock St

Local

Salem

Main St

Endicott St

Howley St

Local

Peabody

Figure 3.13 | Prioritized HIN in the SSC Subregion

A map of the South Shore Coalition (SSC) Subregion, consisting of the coastal communities southeast of Boston. A Prioritized Regional High Injury Network, consisting of highlighted highest-scoring roadway segments, is overlayed on the map. This area has high-scoring segments in Quincy, Randolph, Brockton, Braintree, Marshfield, and Nantasket Beach.

Table 3.9 | High-Scoring Locations in the SSC Subregion

Road

From

To

Ownership

Municipality

Middle St

Main St

Essex St

Local

Weymouth

Pleasant St

Main St

Park Ave

Local

Weymouth

Granite St / Franklin St

I-93

Washington St

State

Braintree

Union St

Washington St

Pilgrims Hwy

Local

Braintree

Center Ave / Market St

Central St

Liberty St

State

Rockland

Figure 3.14 | Prioritized HIN in the SWAP Subregion

A map of the SouthWest Advisory Planning Committee (SWAP) Subregion, consisting of communities to the far southwest of Boston. A Prioritized Regional High Injury Network, consisting of highlighted highest-scoring roadway segments, is overlayed on the map. This area has high-scoring segments in Framingham, Milford, Medway, Bellingham, and along Route 1 southeast of Wrentham

Table 3.10 | High-Scoring Locations in the SWAP Subregion

Road

From

To

Ownership

Municipality

Main St / E Main St

Prospect St

Fortune Blvd

Local

Milford

Medway St

E Main St

I-495

Local

Milford

US1 / Washington St

Thurston St

Madison St

State

Wrentham

Main St

Coffee St

Pond St

Local

Medway

Pulaski Blvd

S Main St

Bellingham St

Local

Bellingham

Figure 3.15 | Prioritized HIN in the TRIC Subregion

A map of the Three Rivers Interlocal Council (TRIC) Subregion, consisting of communities to the south of Boston centered on Norwood. A Prioritized Regional High Injury Network, consisting of highlighted highest-scoring roadway segments, is overlayed on the map. This area has high-scoring segments in Westwood, Norwood, Walpole, Dedham, and Randolph.

Table 3.11 | High-Scoring Locations in the TRIC Subregion

Road

From

To

Ownership

Municipality

Brook Rd

Blue Hills Pkwy

Reedsdale Rd

Local

Milton

Rt 28 / N Main St

I-93

Union St

State

Randolph

Pond St / Reed St

Rt 28 / N Main St

High St

Local

Randolph

Blue Hills Ave

Blue Hills Pkwy

Valentine Rd

State

Milton

Providence Hwy

Washington St

Elm St

State

Dedham

High-Risk Network

While the HIN identifies locations with a high concentration of crashes, the risk-based (or systemic) analysis and high-risk network (HRN) focuses on locations with a high risk of severe crashes, regardless of crash history. The HRN uses roadway features tied to the region’s most severe crash types to identify corridors and intersections that shar e these features. Corridors and intersections that have many features in common with areas where severe crashes have already occurred are deemed to have the highest risk for future severe  crashes. This proactive approach enables road owners to prioritize higher-risk locations for preventative safety improvements before a significant number of severe crashes take place.

The process to develop a HRN follows the process recommended by the Federal Highway Administration (FHWA) in its Systemic Safety User Guide. The process identifies facility types where the crashes are most likely to occur, then calculates a risk score where locations with higher risk scores are more likely to have crashes of a specific type. The risk score is then used to categorize either intersections, segments, or municipalities into the following types:

Six of these networks were developed, one for each of the region’s key emphasis areas. Figure 3.16 shows an example of the HRN for lane departure crashes. The full list of focus facility types and risk factors identified for each regional emphasis area is provided in Appendix D, along with a summary of sites by jurisdiction, risk category, a detailed methodology, and all underlying data.

The focus crash types considered in the HRN are consistent with the Massachusetts SHSP Emphasis Areas and the supporting countermeasures are in alignment with MassDOT and FHWA guidance.

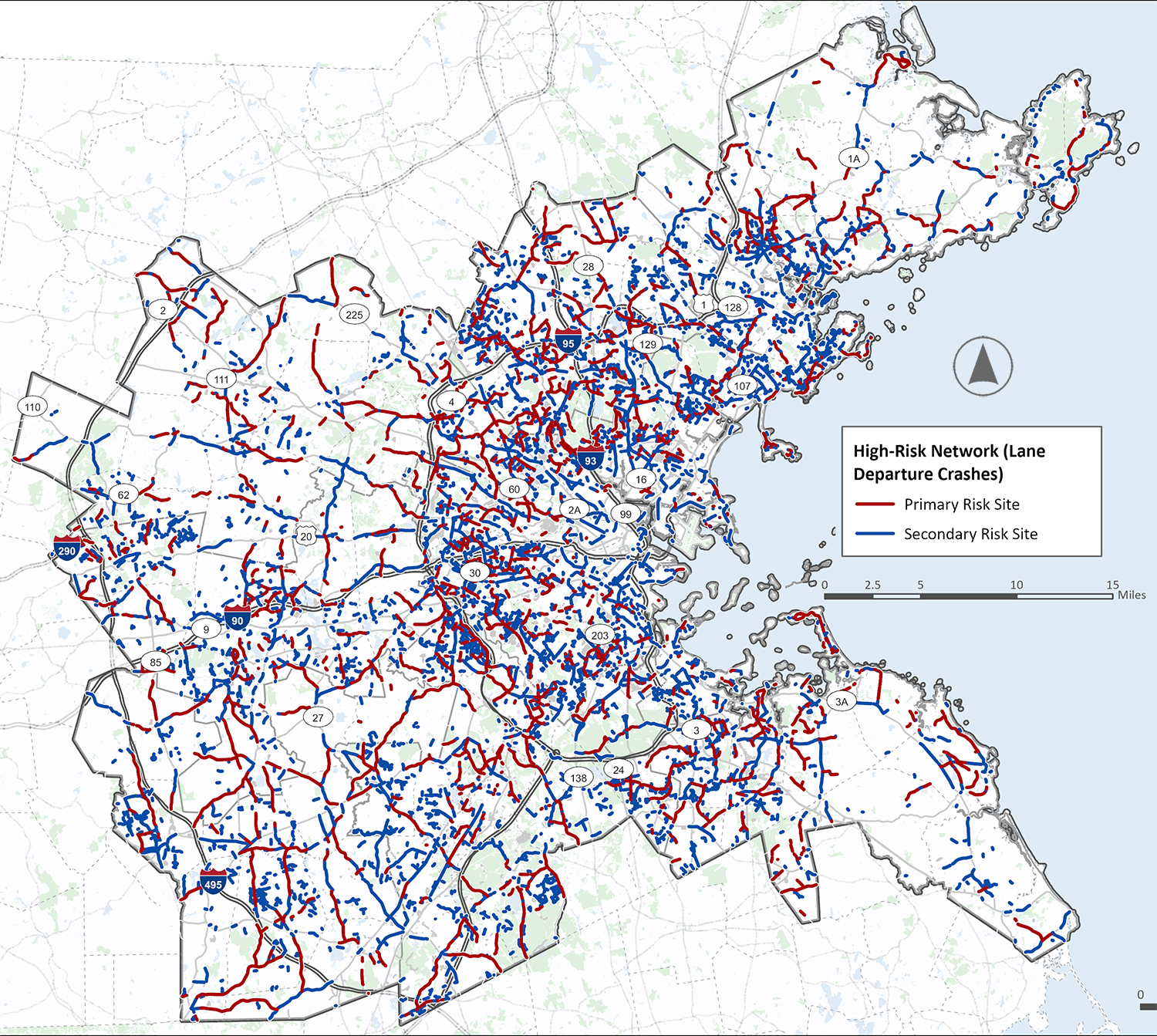

Figure 3.16 | High-Risk Network Example—Lane Departure Crashes

A map of the Boston area with the MPO region enclosed in a border. A High Risk Network for Lane Departure Crashes is overlaid on the map highlighting primary and secondary risk sites. Most sites are concentrated within Route 95 around and to the north of Boston, but risk sites are present throughout most of the larger region.

How to Use the Regional Vision Zero Network Analysis

As described above, the Boston Region Vision Zero Action Plan uses two key tools: the prioritized HIN and the HRN. The HIN can help roadway owners and stakeholders pinpoint locations that have already proven to be dangerous, guiding a deeper look into why those crashes occurred. The HRN, on the other hand, takes a proactive approach by identifying locations with characteristics known to contribute to crashes, even if they haven't had a high number of reported incidents yet. Both networks serve as a starting point for more detailed investigations into safety concerns at specific locations. Both networks can be further explored using an online interactive map on our website https://www.bostonmpo.org/visionzero. This tool will allow stakeholders to understand what these networks mean for their communities. The countermeasures and strategies in Chapter 5 will also guide how the region can address the roadway safety and risk challenges identified in this plan.

4 Public and Stakeholder Engagement

Engagement is crucial to develop a successful Vision Zero Action Plan that directly addresses the region’s transportation safety challenges. By engaging a wide variety of stakeholders, the MPO was able to collect meaningful insight into the region’s biggest safety concerns and identify where the Action Plan should focus its efforts. Engagement activities also identified potential and preferred solutions that can make the Boston region’s streets safer for all people who walk, roll, bike, ride transit, and drive.

Engagement Strategy and Goals

Vision Zero Action Plan Engagement Goals

As communities in the Boston region range from relatively rural towns (such as Dover) to larger urban centers (e.g., Boston and Cambridge), the MPO developed an engagement strategy to ensure input was collected from the wide array of diverse perspectives within the MPO’s jurisdiction.

Depth of Engagement Activities: 4 Meetings of the 18-member Task Force. 36 Municipal Survey Community Respondents. 6 Municipal Virtual Office Hour Participants. 761 Public Survey Respondents (representing 58 municipalities). 921 Safety Concerns Map Submissions. 37 First Virtual Public Forum Participants. 14 HIN Municipal Office Hours Participants. 8 Focus Group with Adults with Disabilities Participants. 13 Municipal Policy Stakeholders Interviewed. 9 Roundtable Participants with Aging Services Providers. 4 Safety Discussions with Chambers of Commerce Representatives. 5 Law Enforcement Municipal Roundtable Participants. 8 Department of Planning and Public Works Roundtable Participants.

The MPO also leveraged a diverse range of communication tools to share updates about the project, collect input, and invite stakeholders to participate in plan development:

Community Partners Toolkit

The MPO shared this with 75 CBOs in the region to help spread awareness of the Action Plan development among various audiences. The toolkit includes a variety of messages and tools in “ready to share” format.

Community Partners Toolkit

The MPO shared this with 75 CBOs in the region to help spread awareness of the Action Plan development among various audiences. The toolkit includes a variety of messages and tools in “ready to share” format.

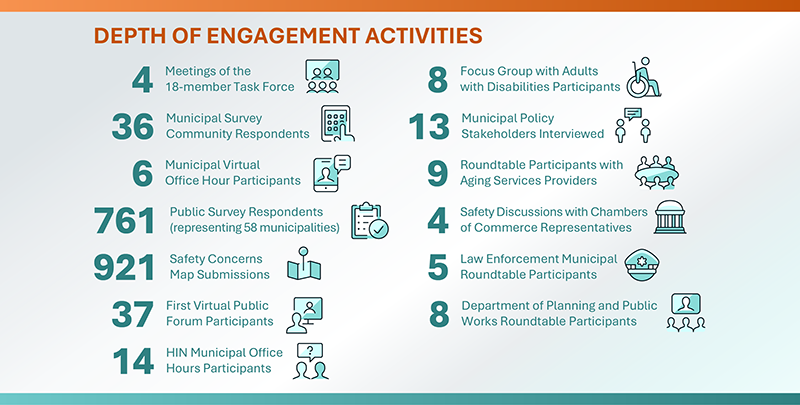

The engagement timeline is shown in Figure 4.1.

A timeline of engagement for the Action Plan, beginning in February 2024 and extending to June 2025. The timeline includes eight task force meetings, the project website launch, a public survey, policy interviews, the distribution of a community partners toolkit, and additional stakeholder meetings.

Appendix F describes the purpose of each individual engagement activity or communication tool and provides an overview of participants for each engagement activity, as well as the intended audience or type of attendee.

Vision Zero Task Force

Vision Zero Task Force input is key to shaping an action plan that shifts the region away from the status quo. Task Force members brought perspectives from municipalities; school systems; pedestrian, bike, accessibility, and public health organizations; and state and federal transportation agencies. In addition to the full Task Force, the MPO also designated three Subcommittees focused on safety analysis, engagement, and policy. The members of the Task Force are show in Table 4.1 .

Table 4.1 | Vision Zero Task Force Members

Name

Affiliation

Daniel Albert

Historian, Writer, Resident of Marblehead

Ari Belathar

Former Executive Director, Boston Cyclists Union

Kristopher Carter

Chief Possibility Officer, MassDOT

Jacqueline DeWolfe

Director of Mobility Policy and Program Development, MassDOT

Alex Epstein

omerville Alliance for Safe Streets Steering Committee

Charlotte Fleetwood

Senior Transportation Planner, Boston Transportation Department

JR Frey

Town Engineer, Town of Hingham

James Fuccione

Executive Director, Massachusetts Healthy Aging Collaborative

Catherine Gleason

Public Policy Manager, Liveable Streets Alliance

Tina Hein

Vice Chair Select Board, Town of Holliston; Massachusetts Safe Routes of School Outreach Coordinator

Brendan Kearney

Co-Executive Director, WalkMassachusetts

Jeremy Marsette

Town Administrator, Town of Sherborn

Galen Mook

Executive Director, MassBike

Shavel’le Oliver

Executive Director, Mattapan Food and Fitness Coalition

Kathryn Quigley

Deputy Director of Strategic Planning, MBTA Systemwide Accessibility

Brad Rawson

Director, Mobility Division, City of Somerville

Katarina Torres Radisic

Riders Transportation Access Group (RTAG)

Ryan Williams

City Councilor, City of Melrose

Stephen Winslow

City Councilor, City of Malden

Task Force member participation informed several essential sections of the Action Plan’s development. The Task force guided public and stakeholder engagement, the safety analysis, policy and process review, and selection of strategies and countermeasures for implementation. Additionally, combined feedback from the Task Force and municipalities helped refine and finalize this project’s HIN.

Who We Heard From

Across all activities, participants included members of the general public, municipal planners and engineers, municipal law enforcement officers, other municipal staff, individuals with disabilities, Aging Service Access Point staff, Chambers of Commerce staff, and members of community-based and advocacy organizations. Table 4.2 lists all major engagement activities and who was involved.

Table 4.2 | Vision Zero Action Plan Engagement Activities

Engagement Activity

Dates Completed

Purpose

Number of Attendees/
Respondents

Type of Attendee/Audience

Task Force

February 13, 2024

October 2, 2024

October 9, 2024

December 16, 2024

December 19, 2024

February 3, 2025

May 2, 2025

June 16, 2025

Provide input and guidance about the development of the Vision Zero Action Plan, including meetings with safety analysis, engagement, and policy subcommittees

18 Task Force members

Representation from multiple levels of municipal leadership; advocates for walking, biking, schools, and accessibility; and state and Federal partners

Municipal Survey

Opened:
September 24, 2024

Closed:
October 4, 2024

Collect input from municipal staff about transportation safety issues, challenges to improving safety, and priorities. Paired with municipal virtual office hours

Submissions from 36 municipalities

Planners, City Councilors, Public Works staff, Town Engineers, Housing and Economic Development Staff

Municipal Virtual Office Hours

September 25, 2024, 11:00 AM

Collect input from municipal staff about transportation safety issues, challenges to improving safety, and priorities. Paired with municipal survey

6 attendees

Planners, City Councilors, DPW directors, Town Engineers, Transportation Planners, Housing and Economic Development Staff

Public Survey

Opened:
October 17, 2024

Closed:
February 14, 2025

Collect input from members of the general public about perceived transportation safety concerns and desired solutions

761 submissions from people who live across 58 municipalities within region

General public

Safety Concerns Comment Map

Opened:
October 17, 2024

Closed:
April 2, 2025

Collect input from members of the public about perceived transportation safety concerns and desired solutions at specific locations throughout the region

921 submissions identifying 3,952 safety concerns across 55 municipalities within region

General public

Virtual Public Forum

January 29, 2025, 6:00 PM

Present overview and purpose of Vision Zero Action Plan and region’s safety data; learn about public’s perspectives on safety challenges, concerns, and solutions

37 attendees

General public

High Injury Network Municipal Virtual Office Hours

March 3, 2025

March 6, 2025

Discuss the draft HIN and HRN methodology and maps

14 attendees on March 3

8 attendees on March 6

Municipal Planners, Public Works Directors, Town Engineers, Law Enforcement

Policy Interviews

November 2024 through May 2025

Identify policies and processes that might be missing, that inhibit safety, or need additional resources to implement successfully

13 interviews

Municipal Planners, Public Works Directors, Town Engineers; Massachusetts Department of Conservation and Recreation; Massachusetts Executive Office of Public Safety and Security Office of Grants and Research

Focus Group—Adults with Disabilities

April 14, 2025, 5:30 PM

Understand how stakeholders with disabilities that impact their mobility travel and maneuver safely around the region

8 attendees

Adults with Disabilities in the Boston region

Aging Services Access Point Providers Roundtable and follow-up Older Adults Survey

April 16, 2025, 2:00 PM  

Understand how older adults travel and their perceptions about traffic safety challenges and needs in the region

7 attendees (Discussion)

2 submissions (Survey)

ASAP Directors and Staff

Discussion on Roadway Safety—Chambers of Commerce

April 17, 2025, 2:00 PM  

Understand the business community’s perceptions of safety challenges and efforts to improve safety

3 attendees; 1 follow-up conversation

Chambers of Commerce Staff

Municipal Roundtable—Law Enforcement

May 8, 2025, 10:00 AM

Discuss potential solutions and strategies to address identified safety issues, from an enforcement perspective

5 attendees

Municipal Law Enforcement

Municipal Roundtable—Departments of Public Works and Planning

May 9, 2025, 10:00 AM

Discuss potential solutions and strategies to address identified safety issues, from a municipal perspective

7 attendees; 1 follow-up conversation

Municipal Planners and DPW Staff

Engagement Takeaways

Across all engagement efforts, several key takeaways emerged about dangerous driver behaviors, roadway design and maintenance needs, policies influencing roadway safety, and funding gaps.

Driver Behavior

People shared their mistrust of other road users—people do not trust others to make the right or safest decisions. For example, pedestrians do not trust drivers to stop for them at intersections or crosswalks; drivers do not trust other drivers to drive unimpaired or distraction-free; and bicyclists do not trust that drivers will give them enough space or keep bicycle lanes free of barriers (such as parked cars).

TOP REPORTED DRIVER BEHAVIOR CONCERNS:

Roadway Design and Maintenance

Roadway design, geometry, and infrastructure conditions play key roles in people’s travel patterns and mode choices. Roadway designs that allow vehicles to travel at high speeds can inhibit awareness of pedestrians and bicyclists. When people feel unsafe biking or walking they are more likely to travel by vehicle. At the same time, some motor vehicle drivers feel unsafe while driving due to confusing roadway geometry, coupled with speeding and aggressive driving behaviors by others.

TOP REPORTED INFRASTRUCTURE CONCERNS:

Roadway Policies

Public policy and decision-making processes determine what safety priorities people and organizations will focus on, as well as how, when, and who can select, implement, and evaluate roadway safety solutions. While the Commonwealth and the region have many proactive and supportive safety policies and processes, stakeholders identified several policy areas where change is needed. Organizations that will lead and support policy changes include the MPO, municipalities, MassDOT, the Massachusetts General Court, and advocacy and non-profit organizations.

POLICY AND PROCESS SUGGESTIONS INCLUDE:

Funding

Many municipal stakeholders, including planners, public works staff, and law enforcement officers, identified lack of funding and funding inflexibility as critical challenges to undertaking more roadway safety improvements. This sentiment was expressed across many engagement activities, including the municipal survey, virtual office hours, interviews, and roundtables. Stakeholders want to address roadway safety in a holistic and comprehensive manner but have insufficient resources to do so. While quick-build, low-cost improvements can improve safety outcomes in some cases, many proven safety countermeasures are resource- and time-intensive. Staff capacity can also be a challenge, especially for smaller municipal departments with many shared responsibilities.

5 Strategies, Policies, Countermeasures, and Plan Implementation

This Vision Zero Action Plan offers a comprehensive set strategies, countermeasures, and implementation resources to address regional traffic safety challenges identified throughout the Action Plan development process.

Proven Safety Countermeasures and Best Practices

Safety improvements in the region should be guided by the data analysis, prioritized HIN and HRN mapping (Chapter 3), and stakeholder engagement feedback (Chapter 4). The National Highway Traffic Safety Administration (NHTSA) and the FHWA provide guidance on the application and impact of Proven Safety Countermeasures to address speeding, pedestrian and bicyclist safety, roadway departure, intersections, and crosscutting safety improvements. These measures should be considered for widespread implementation to address unsafe infrastructure and dangerous driving in the region. More information and guidance on Proven Safety Countermeasures can be found in Appendix H.

Additional best practice resources include:

Funding for Implementation

In addition to pursuing funding through the MPO’s TIP (see: https://www.bostonmpo.org/tip), other programs are available to provide funding to implement projects described in this Action Plan, as safety-focused projects, or as part of other, broader initiatives, depending on the countermeasure and project.

Policies that Require Legislative Changes

Some strategies require legislative changes in the Massachusetts General Court. As Action Plan implementation continues, the MPO will track roadway safety bills and help communicate the role and importance of these policies to stakeholders. These policies are explained in detail in Appendix G and summarized here:

Vision Zero Action Plan Strategies

A critical part of implementation of the regional Vision Zero Action Plan will be for the MPO to continue engagement with municipal partners to refine the prioritized HIN, understand more about the causes of crashes at high priority locations, and create communication and education materials to continue to spread awareness of Vision Zero and the Safe System Approach. The strategies below also identify the key actions that municipal partners should consider to address high priority crash and risk locations.

Action Plan strategies are organized by emphasis area (Intersections, Lane Departure, Vulnerable Road Users, Older Drivers, Speeding, and Large Vehicles) and include policies, process changes, education and engagement, enforcement, and infrastructure best practices. Each action identifies a lead agency and supporting partners. Actions are grouped by timeframe for implementation (short-term: 1–3 years; medium-term: 3–5 years; long-term: 5 or more years; and, ongoing: actions that will recur or happen annually). These actions are supported by input gathered during stakeholder engagement, as well as Vision Zero implementation best practices (refer to Appendix F for more detail).

Cross-cutting

Cross-cutting Actions

Cross-cutting actions span across every emphasis area to reflect the MPO’s commitment to saving lives. Cross-cutting action items reinforce the guiding principles of the Safe System Approach: death and serious injuries are unacceptable, humans make mistakes, humans are vulnerable, responsibility is shared, safety is proactive, and redundancy is crucial.

Action

Lead

Support

Timeframe1

Type

Develop engaging messaging and educational materials to raise awareness about key crash causes and best practice interventions (including street design changes).

Boston Region MPO

Short-term

Process

Transition the MPO's Regional Vision Zero Task Force to a Regional Action Plan Implementation Task Force.

Boston Region MPO

Short-term

Process

Work with municipalities, MassDOT, and public health stakeholders to involve public health professionals in roadway safety efforts including local public health staff and epidemiologists as well as staff from the Massachusetts Department of Public Health's Injury Prevention and Control Program.

Boston Region MPO

Municipalities/
MassDOT

MAPC Public Health Team

Short-term

Process

Coordinate with municipalities to explore the need for roadway safety educational materials that can be used to facilitate communication with the business community.

Boston Region MPO

Municipalities

Short-term

Process

Create a toolkit of engineering countermeasures, including typical dimensions and specifications or standard drawings, drawing from local best practices (Boston, Cambridge, Somerville guides), MassDOT, NACTO, FHWA, and AASHTO guides.

Boston Region MPO

MassDOT

Medium-term

Process

Further analysis of the prioritized HIN and coordination with municipalities to understand key crash types, causes, and locations (intersection vs. corridor) to develop interventions (including quick-build solutions).

Boston Region MPO

Municipalities/MassDOT

Medium-term

Process

Work to align MPO planning and programming with Vision Zero goals and Safe System principles.

Boston Region MPO

Medium-term

Process

Conduct a data gap analysis and explore public health datasets ((e.g., hospital records, EMS data, syndromic surveillance, trauma registries) to explore and analyze further the causes of injury.

Boston Region MPO

Medium-term

Data

Plan and host peer exchanges to share best practices and problem solving with municipal planners, Depts of Public Works, law enforcement, elected officials, school leaders, and first responders.

Boston Region MPO

Ongoing

Process

Provide annual progress reports on the Regional Vision Zero Action Plan implementation.

Boston Region MPO

Ongoing

Process

Track state legislative changes related to roadway safety and communicate priority bills and safety impacts to stakeholders.

Boston Region MPO

Vision Zero and safe streets advocates

Ongoing

Process

Research the potential of new technology solutions and share information with municipal and state partners, including intelligent speed assist and intelligent transportation system technologies such as adaptive signal control and vehicle-to-infrastructure communication.

Boston Region MPO

Municipalities/
MassDOT

Ongoing

Process

Incorporate HIN and HRN data and analysis into corridor reconstruction and maintenance projects so that safety improvements and best practices can be integrated with every municipal project, as appropriate.

Municipalities

MassDOT

Short-term

Infrastructure

Adopt a local Vision Zero policy and goal

Municipalities

Short-term

Policy

Consider locations where pilot or quick-build traffic calming projects would be appropriate. Collect before and after data to evaluate the project and communicate findings with stakeholders and residents.

Municipalities

Boston Region MPO

Medium-term

Process/Infrastructure

Establish a municipal Vision Zero Task Force or Working Group to foster a collaborative, data-driven, and equitable approach to traffic safety within the municipality and to review serious crashes when they do occur.

Municipalities

Boston Region MPO

Medium-term

Process

Implement a systemic program to assess and improve street lighting, with a priority on locations with documented nighttime crashes involving vulnerable road users (pedestrians, cyclists, transit riders). This includes evaluating existing lighting levels, identifying dark or poor contrast zones, and deploying modern, high-efficiency lighting solutions to create safer conditions.

Municipalities

Boston Region MPO

Long-term

Process/
Infrastructure

Request MPO technical assistance for planning and design of intersection and corridor safety improvements.

Municipalities

Ongoing

Process

1   Timeframes: Short-term: 1–3 years; Medium-term: 3–5 years; Long-term: 5+ years

Intersections

Intersection Actions

Intersection safety is a cornerstone of any effective Action plan, as intersections are frequently points of conflict and high-severity crashes. The goal is to design intersections that are forgiving of human error and minimize vehicle speed involved in potential collisions.

Action

Lead

Support

Timeframe1

Type

Develop prioritized list of high-crash intersections and coordinate with municipalities to develop safety interventions.

Boston Region MPO

Municipalities/
MassDOT

Ongoing

Process

Develop and implement a traffic safety signal policy and prioritization framework that includes guidelines for municipal signal changes such as protected left turns, leading pedestrian intervals, pedestrian and cyclist detection and phasing, accessible pedestrian signals, signal timing optimization for safety, clearance intervals, and emergency vehicle pre-emption and transit signal priority.

Municipalities

Medium-term

Policy

Improve crosswalk visibility by installing high-visibility crosswalks or raised crosswalks at all high-volume intersection crossings with a focus on intersections near priority destinations (such as schools, senior centers, hospitals, and transit stops).

Municipalities

MassDOT

Medium-term

Infrastructure

Install pavement markings and physical delineation near crosswalks and intersections to improve sightlines for people driving and walking or rolling (daylighting intersections).

Municipalities

MassDOT

Medium-term

Infrastructure

Install 'no turn on red' signage at signalized intersections on the HIN and HRN.

Municipalities

MassDOT

Medium-term

Infrastructure

Coordinate with the MBTA to improve safety at at-grade rail crossings along the HIN and HRN.

Municipalities

Boston Region MPO/MBTA

Medium-term

Infrastructure

Adopt citywide 'No Turn on Red' policy.

Municipalities

MassDOT

Medium-term

Policy

1   Timeframes: Short-term: 1–3 years; Medium-term: 3–5 years; Long-term: 5+ years

Lane Departure

Lane Departure Actions

Roadway departure crashes, where a vehicle leaves the traveled way and often strikes a fixed object, overturns, or enters a ditch, are a significant contributor to fatalities and serious injuries. This Action Plan will implement a multi-faceted approach to prevent these crashes by recommending more forgiving roadsides, improved driver awareness, and steps to address common contributing factors.

Action

Lead

Support

Timeframe1

Type

Use HIN and HRN to develop list of top locations for roadway departure crashes and roadway departure crash risk.

Boston Region MPO

Short-term

Process

Complement infrastructure improvements with targeted educational campaigns to address behavioral factors contributing to roadway departures, including partnering with state agencies and advocacy groups to conduct public awareness campaigns on the dangers of distracted and drowsy driving; and, enhancing outreach and education about the MA hands-free law.

Boston Region MPO

Municipalities

Medium-term

Process

Use context sensitive roadway departure best practices in areas where roadway departures are a common crash cause, including the installation of high friction pavement, shoulder or centerline rumble strips, wider pavement markings (6-inch edge and centerlines), and retroreflective pavement markings.

Municipalities

MassDOT

Ongoing

Infrastructure

1   Timeframes: Short-term: 1–3 years; Medium-term: 3–5 years; Long-term: 5+ years

Vulnerable Road Users

Vulnerable Road User Actions

Vulnerable Road Users—including pedestrians, bicyclists, individuals using wheelchairs, and those on scooters—are disproportionately affected by traffic crashes, often sustaining severe or fatal injuries due to their lack of physical protection. The MPO, through this Action Plan, is committed to creating a transportation system that prioritizes the safety and comfort of all Vulnerable Road Users, making walking, biking, and rolling safe and accessible modes of travel for everyone.

Action

Lead

Support

Timeframe1

Type

Using the Regional Active Transportation Plan, prioritize closing identified gaps in the bicycle and pedestrian network aligned with the HIN and HRN. Focus on prioritizing connections to transit, schools, hospitals, and commercial centers.

Municipalities

Boston Region MPO/
MassDOT

Short-term

Infrastructure

Develop a policy requiring traffic control guidance and design to improve safety for pedestrians and cyclists traveling through municipal-project work zones, ensuring temporary facilities are safe and clear.

Municipalities

Boston Region MPO

Short-term

Policy

Participate in the MassDOT Safe Routes to School (SRTS) program and encourage community groups, committees, or the municipality to join the Massachusetts SRTS Alliance.

Municipalities

Short-term

Process

Improve the safety and visibility of mid-block crosswalks with the installation of signage, high-visibility pavement markings, rapid rectangular flashing beacons (RRFBs) or HAWK signals along high-speed corridors and in proximity to priority destinations.

Municipalities

MassDOT

Medium-term

Infrastructure

Adopt a Complete Streets policy and leverage MassDOT Complete Streets funding opportunities to prioritize and improve walking and biking infrastructure.

Municipalities

Medium-term

Policy

Work with Safe Routes to School to expand educational campaigns and training programs for children and adults focusing on bicyclists and pedestrian skill education, safety-related training, helmet use, etc.

Municipalities

Boston Region MPO

Medium-term

Process

Work to implement school bus cameras to enforce the existing no passing law.

Municipalities

School Districts

Long-term

Policy

1   Timeframes: Short-term: 1–3 years; Medium-term: 3–5 years; Long-term: 5+ years

Older Drivers

Older Adult and Older Driver Actions

Older adults, whether as pedestrians, drivers, or transit users, face unique challenges in the transportation system, often due to changes in vision, hearing, reaction time, or physical mobility. This Action Plan aims to create a transportation environment that is safe, accessible, and accommodating for our aging population, ensuring their continued mobility and independence. The Plan’s strategies will address both infrastructure and behavioral aspects to mitigate risks for older adults and older drivers.

Action

Lead

Support

Timeframe1

Type

Use crash and risk data to prioritize locations to address the safety of older adult roadway users and to target messaging campaigns.

Boston Region MPO

Municipalities/
MassDOT

Short-term

Process

Collaborate with MassDOT and the RMV to help share information and resources about safe driving for older adults, including resources from AAA, AARP, and MIT AgeLab.

Boston Region MPO

MassDOT/RMV

Medium-term

Process

Partner with state and national organizations to educate older adults and their families about advanced vehicle safety features (e.g., blind spot monitoring, lane keeping assist, automatic emergency braking) and encourage the adoption of vehicles equipped with these technologies.

Boston Region MPO

Medium-term

Process

Continue to invest in research and planning that expands and improves public transit options, paratransit services, and community-based transportation programs tailored to the needs of older adults, reducing their reliance on private vehicles.

Boston Region MPO

Long-term

Process

Coordinate with the MBTA to facilitate "travel training" programs that help older adults learn to use public transportation safely and confidently.

Boston Region MPO

Municipalities/
COAs/RTAs

Long-term

Process

1   Timeframes: Short-term: 1–3 years; Medium-term: 3–5 years; Long-term: 5+ years

Speeding

Speeding Actions

Speed is the single most critical factor in crash severity: the faster a vehicle is traveling, the greater the kinetic energy involved in a collision, and thus, the higher the likelihood of severe injury or fatality for all road users, especially vulnerable ones. This Action Plan provides for a comprehensive approach to managing speed through infrastructure design, policy changes, and targeted enforcement, ensuring that speeds are safe and appropriate for all roadway contexts.

Action

Lead

Support

Timeframe1

Type

Expand guidance and provide resources for municipalities to perform speed data collection more effectively, enabling data-driven identification of speeding hot spots and evaluation of countermeasure effectiveness.

Boston Region MPO

Municipalities/
MassDOT

Short-term

Process

Develop and disseminate public awareness materials highlighting the dangers of speeding and the direct correlation between speed and crash severity for all road users.

Boston Region MPO

Municipalities/
MassDOT

Short-term

Process

Research required speed-limiter devices for repeat and/or reckless speeding offenders.

Boston Region MPO

MassDOT

Medium-term

Process

Help spread awareness of and implement MassDOT’s speed management guidance to collect information and analyze data, establish target speeds, design roadways for speed control and separation, set speed limits, and build a community-wide safety culture

Boston Region MPO

Municipalities

Medium-term

Process

Provide guidance to municipalities to develop traffic calming prioritization protocols to help municipal staff communicate to colleagues and residents about when and where traffic calming interventions should be implemented.

Boston Region MPO

Municipalities

Medium-term

Process

Review crash data on speeding related crashes and coordinate with municipalities and MassDOT to identify pilot locations for automated speed and red light safety cameras.

Boston Region MPO

Municipalities/
MassDOT

Medium-term

Process

Adopt a 25 mph speed limit in municipality-owned high-density and business districts, as authorized by Chapter 90, Section 17C of the MGL.

Municipalities

Short-term

Policy

Establish safety zones and school zones along municipal-owned roadway corridors to lower speed limits to 20 mph.

Municipalities

Short-term

Policy

Prioritize traffic calming street design changes on local and collector streets in areas at a high-risk for speeding-related crashes, such as residential neighborhoods, school zones, and commercial districts. Traffic calming interventions include road diets, raised intersections or crosswalks, speed humps, narrowing travel lanes, and gateway treatments.

Municipalities

MassDOT/
Boston Region MPO

Medium-term

Infrastructure

1   Timeframes: Short-term: 1–3 years; Medium-term: 3–5 years; Long-term: 5+ years

Large Vehicles

Large Vehicle Actions

Large vehicles, including commercial trucks, buses, and municipal fleets, present unique safety challenges due to their size, weight, blind spots, and longer stopping distances. Crashes involving large vehicles often result in severe outcomes, particularly for vulnerable road users. The Action Plan provides a commitment to mitigating these risks by promoting safer vehicle design, implementing robust fleet policies, and designing infrastructure that accounts for the operational characteristics of large vehicles.

Action

Lead

Support

Timeframe1

Type

Develop educational materials that municipalities can use for awareness campaigns for commercial motor vehicle (CMV) drivers on how to better share the roadway and improve safety for all (e.g., Share the Road Campaigns).

Boston Region MPO

Municipalities/
MassDOT

Short-term

Process

Develop and model safe fleet transition plan for municipalities to adopt.

Boston Region MPO

Municipalities

Medium-term

Process

Collaborate with MassDOT to promote local adoption of safety measures on large vehicles and municipal fleets according to Massachusetts Acts of 2022 Chapter 358—An Act to Reduce Fatalities, including installing side guards, backup cameras, and cross-over mirrors, as well as prohibition of hazardous aftermarket devices like bull bars and lifted suspensions. Provide guidance to municipalities on effectively incorporating these safety requirements into residential parking permit programs to encompass privately owned vehicles.

Boston Region MPO

MassDOT

Medium-term

Process

Establish clearly defined and safely designed loading/unloading zones.

Municipalities

Short-term

Process

Adopt a ‘safe fleet’ policy that outlines municipal fleet owners’ commitment to safer vehicles with higher direct vision. This policy should draw on Boston's and New York City's Safe Fleet Transition Plans and should include:

  • Safety Technology Requirements: Mandate the installation of side guards, blind zone cameras, white noise backup alarms, intelligent speed assist, and other proven safety technologies on all new and existing municipal fleet vehicles; prohibition of hazardous aftermarket modifications (per Chapter 358 of Acts of 2022); and provide templates for incorporating these safety requirements in all municipal contracts.
  • Driver Training: Require ongoing, specialized safety training for all municipal vehicle operators, with a focus on vulnerable road user awareness, safe turning maneuvers, and blind spot recognition.
  • Vehicle Maintenance Standards: Establish rigorous maintenance schedules and inspection protocols to ensure all safety features are fully operational.

Municipalities

Boston Region MPO

Medium-term

Policy

1   Timeframes: Short-term: 1–3 years; Medium-term: 3–5 years; Long-term: 5+ years

Other Strategies for the Boston Region

As noted, other road safety issues also cause death and injury on the region’s roads, and the MPO encourages its partners to continue to take action in these areas as well.

Notably, Post Crash Care is identified as an element of the Safe System Approach and a part of MassDOT’s SHSP to provide expedient access to EMS (emergency medical services) care and support the work of first responders. According to NHTSA, 40 percent of 2021 crash victims nationally were alive when first responders arrived, but later died. Thus, delivering medical care can clearly and dramatically improve crash outcomes.

The region is known for its world-class hospitals and multiple Level 1 adult and pediatric trauma centers. However, the MPO and its cities and towns can take additional steps to leverage Post Crash Care to help achieve Vision Zero:

Cutting Edge Strategies and Countermeasures

States, communities, and other countries are pioneering many other innovative approaches to highway safety. Several emerging strategies are listed in Table 5.1 that could be considered for the Boston region.

Table 5.1 | Innovative Countermeasures and Strategies

Issue

Strategy/Countermeasure

Intelligent Transportation Systems (ITS)

Intelligent Transportation Systems (ITS): Encompasses a range of digital transportation infrastructure that can include a wide spectrum of use cases for connected vehicles, vehicle-to-everything (V2X) communication, and artificial intelligence. These technologies hold tremendous promise to improve safety and mobility.

Lane Departures

Advanced Driver-Assistance Systems (ADAS): Advanced driver-assistance systems provide real-time alerts and automated interventions to prevent lane departures.

Roadway Departure Prevention Systems: Innovations in systems that prevent vehicles from leaving the roadway, such as haptic feedback and drive-by-wire systems, are being evaluated for their effectiveness in emergency situations.

Distracted Driving

Automated Distracted Driving Detection: New safety camera technology is available that can monitor phone use of drivers, bother for the purpose of enforcement and to better diagnose distracted driving trends.

Impaired Driving

Specialty OWI Courts: Massachusetts has a number of drug courts, but many states have begun leveraging DUI courts specifically to offer individualized supervision and treatment for high risk impaired driving offenders.

Increased Drug Recognition Training: In addition to training police officers as Drug Recognition Experts (DRE), some law enforcement agencies have set goals to have all of their traffic officers certified in Advanced Roadside Impaired Driving Enforcement (ARIDE), a course offered by the Massachusetts Municipal Police Training Committee.

6 Progress and Transparency

Achieving the Boston region’s goal of eliminating fatal and serious injury crashes by 2050 will require collaboration and sustained effort among all regional transportation safety stakeholders including: planners, road owners, maintenance, law enforcement, first responders, the public, advocacy groups, engineers, policy makers, EMS, and community-based organizations.

Boston Region MPO’s Role in Improving Transportation Safety

The MPO will continue to play a critical role in enhancing transportation safety by leading implementation of several Vision Zero action items to advance the region toward a Safe System.

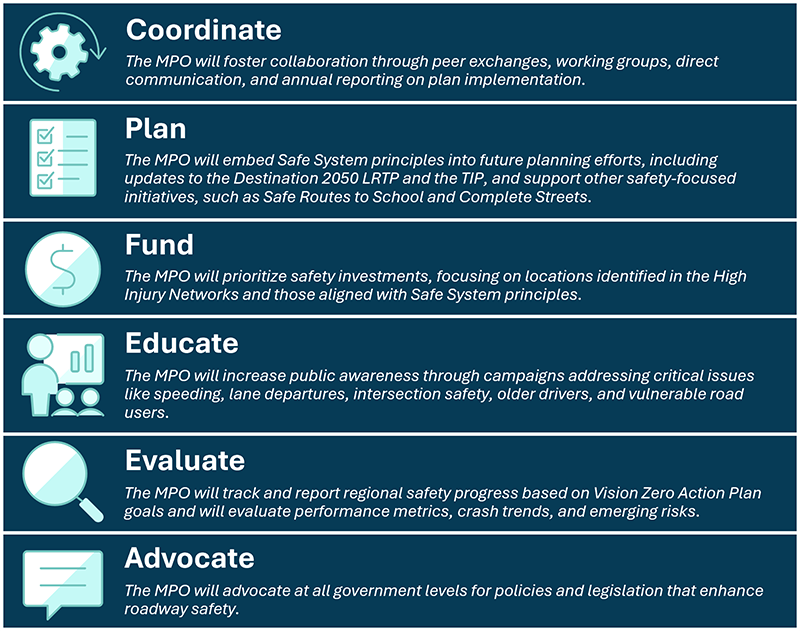

Coordinate: The MPO will foster collaboration through peer exchanges, working groups, direct communication, and annual reporting on plan implementation. Plan: The MPO will embed Safe System principles into future planning efforts, including updates to the Destination 2050 LRTP and the TIP, and support other safety-focused initiatives, such as Safe Routes to School and Complete Streets. Fund: The MPO will prioritize safety investments, focusing on locations identified in the High Injury Networks and those aligned with Safe System principles. Educate: The MPO will increase public awareness through campaigns addressing critical issues like speeding, lane departures, intersection safety, older drivers, and vulnerable road users. Evaluate: The MPO will track and report regional safety progress based on Vision Zero Action Plan goals and will evaluate performance metrics, crash trends, and emerging risks. Advocate: The MPO will advocate at all government levels for policies and legislation that enhance roadway safety.

The MPO will utilize this Action Plan (see the actions tracking table in Appendix J) to track and report regional safety progress based on Action Plan goals, using both outputs and outcomes on an annual basis. Outputs track and report on the progress of the MPO in supporting, promoting, and leading safety initiatives, programs, policies, plans, and projects. Outcomes evaluate the effectiveness of safety programs and investments in reducing crash frequency and severity, and evaluation findings are used to strengthen successful strategies and revise or discontinue ineffective ones.

The MPO will track performance annually through quantitative analysis of the performance metrics listed in Table 6.1 and Table 6.2. While similar metrics are tracked statewide in the SHSP, these metrics will be tracked specifically for the Boston region and publicly reported by the MPO.

Table 6.1 | Vision Zero Action Plan Performance Metrics (All Roads)

Metric

Baseline (5 Year Average 2018–2022)

Year 1—Annual Number

Year 1—Rolling 5-year Average

Number of Fatal Crashes in Boston MPO region

113

Number of Fatalities

117

Rate of Fatal Crashes (per 100,000 population)

3.43

Number of Serious Injury Crashes

841

Number of Serious Injuries

966

Rate of Serious Injury Crashes (per 100,000 population)

25.52

Table 6.2 | Vision Zero Action Plan Performance Metrics (Interstates, Expressways, Other Fully Access-Controlled Roads, and Ramps)

Metric

Baseline (5 Year Average 2018–2022)

Year 1—Annual Number

Year 1—Rolling 5-year Average

Percent Change in Fatal and Serious Injury (FSI) Crashes Involving Large Trucks

4%

Percent Change in FSI Crashes Involving Older Drivers

5%

Percent Change in FSI Crashes Involving Speeding

18%

Percent Change in FSI Crashes Involving Intersections

1%

Percent Change in FSI Crashes Involving Lane Departure

9%

Percent Change in FSI Crashes Involving Vulnerable Road Users

3%

7 Next Steps

The Boston Region Vision Zero Action Plan represents a critical step forward in our commitment to eliminating traffic fatalities and serious injuries by 2050. Through a thorough analysis of crash data, extensive public and stakeholder engagement, and a deep dive into policy and infrastructure, we identified key areas of concern such as intersections, lane departures, and the heightened vulnerability of pedestrians and cyclists. This Action Plan is a regional roadmap built on the Safe System Approach, recognizing that human error is inevitable and that our transportation system must be designed with multiple layers of protection to ensure everyone's safety.

Moving forward, the success of this Vision Zero Action Plan hinges on sustained collaboration and proactive implementation. The MPO will continue to play a central role in coordinating efforts, embedding Safe System principles into future planning, and prioritizing investments in high-risk areas. We will also focus on educating the public, evaluating our progress against clear performance metrics, and researching and providing information to stakeholders about necessary legislative changes. This plan provides a regional framework, but its impact will be measured by the collective actions taken by all stakeholders—from state agencies and municipalities to community organizations and individual road users.Achieving Vision Zero is a shared responsibility, demanding a unified commitment from everyone who uses and shapes our roadways. We urge all stakeholders to actively engage with the strategies and countermeasures outlined in this plan. By working together, leveraging the identified data, and adopting the Safe System Approach, we can transform our streets into safer, more equitable spaces for all. Your active participation is not just encouraged, it is essential to reach Vision Zero in the Boston Region.

Boston Region Vision Zero Action Plan:

A Roadmap to Safer Streets

For more information, visit our website! Achieving Vision Zero is a shared responsibility, demanding a unified commitment from everyone who uses and shapes our roadways. We urge all stakeholders to actively engage with the strategies and countermeasures outlined in this plan. By working together, leveraging the identified data, and adopting the Safe System Approach, we can transform our streets into safer, more equitable spaces for all. Your active participation is not just encouraged, it is essential to reach Vision Zero in the Boston Region.

1         The summaries in this section do not include crashes along Interstates, expressways, other fully access-controlled roadways, or ramps unless otherwise noted.

2         Massachusetts Highway Safety Improvement Program, MassDOT. Source: https://www.mass.gov/info-details/highway-safety-improvement-program.

3        To demonstrate locations in a variety of municipalities in each region, a maximum of two locations from each municipality are included in these lists. There may be more than two high-scoring locations in each municipality.
